November 3 Workday

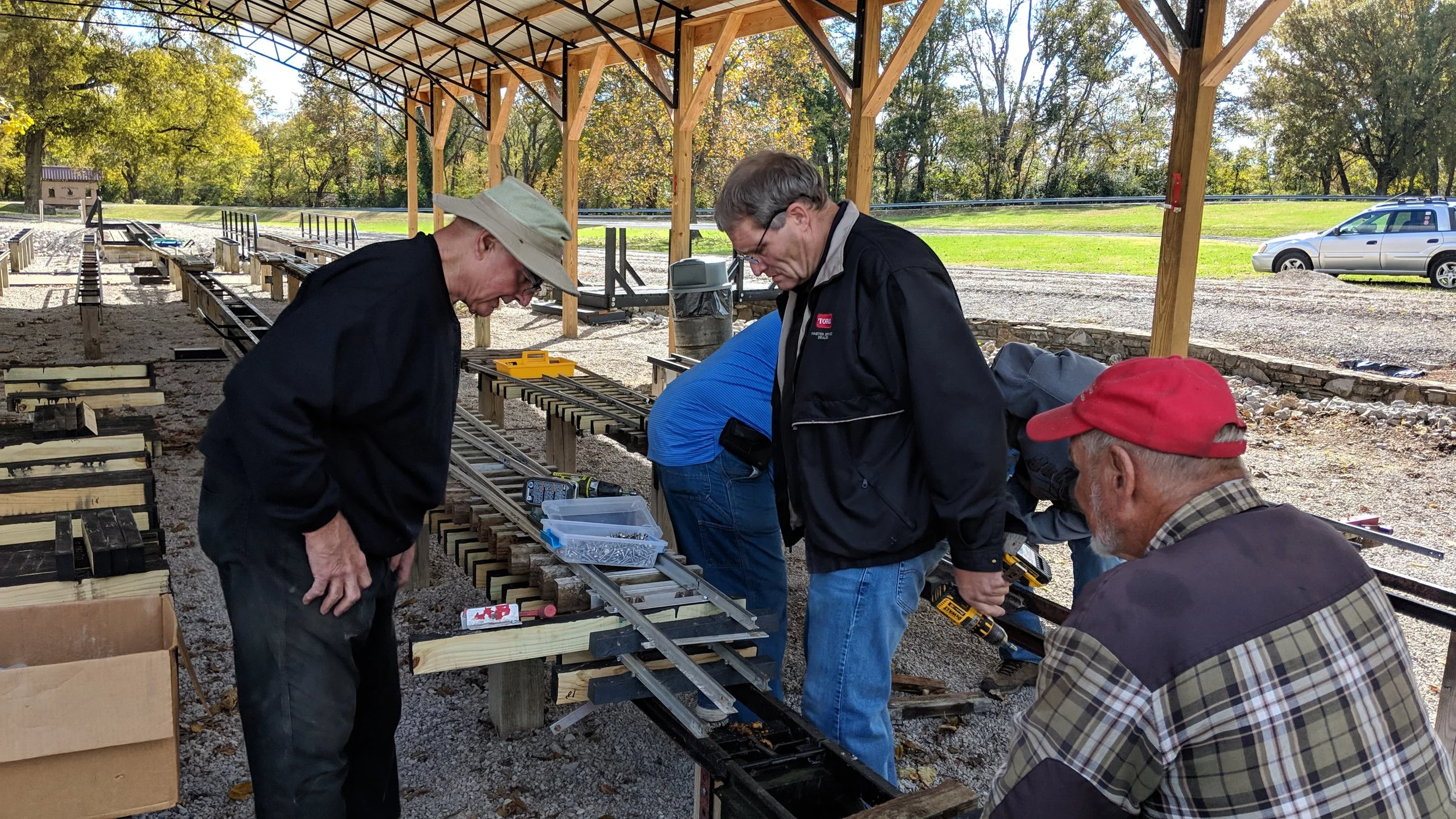

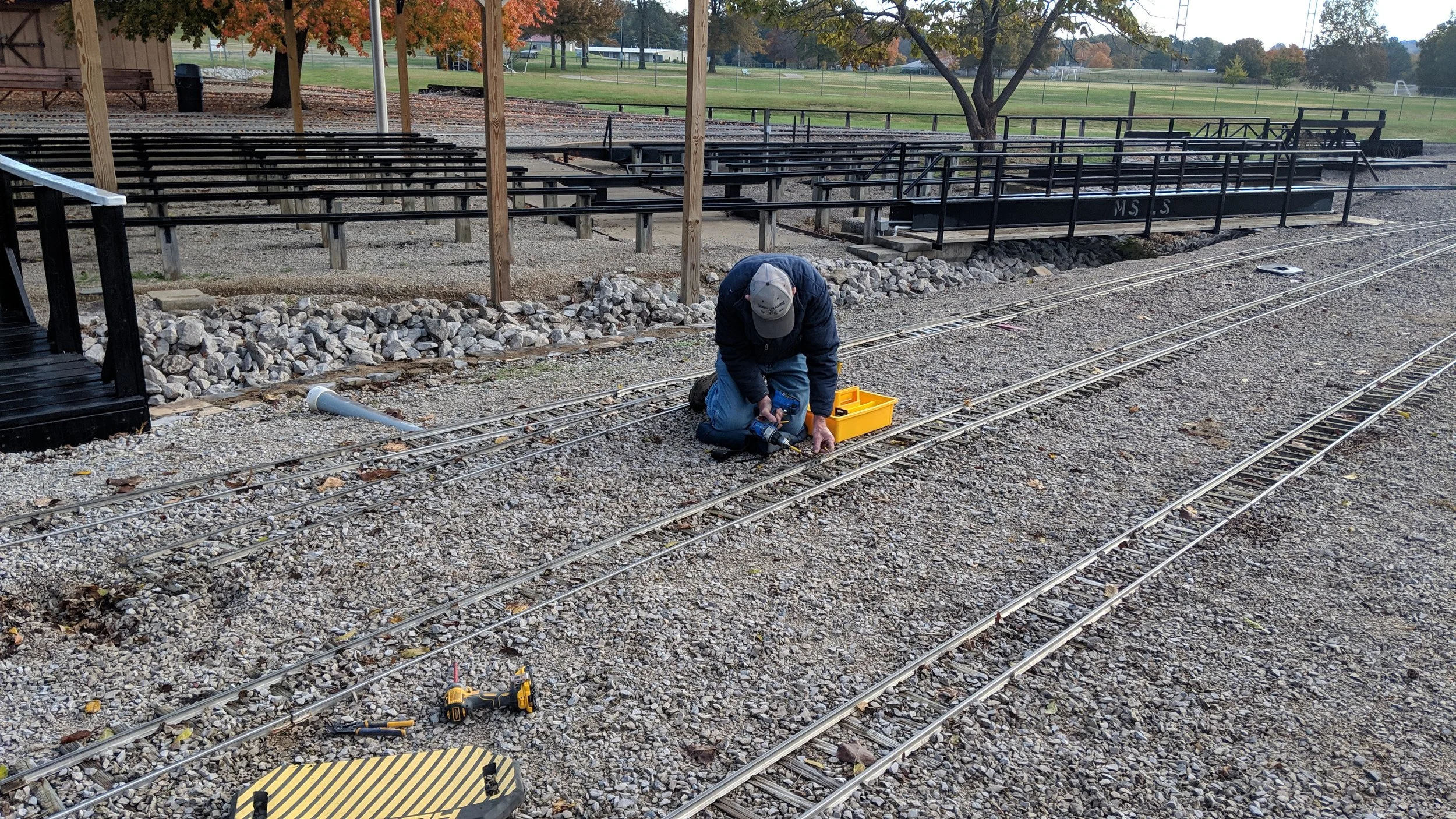

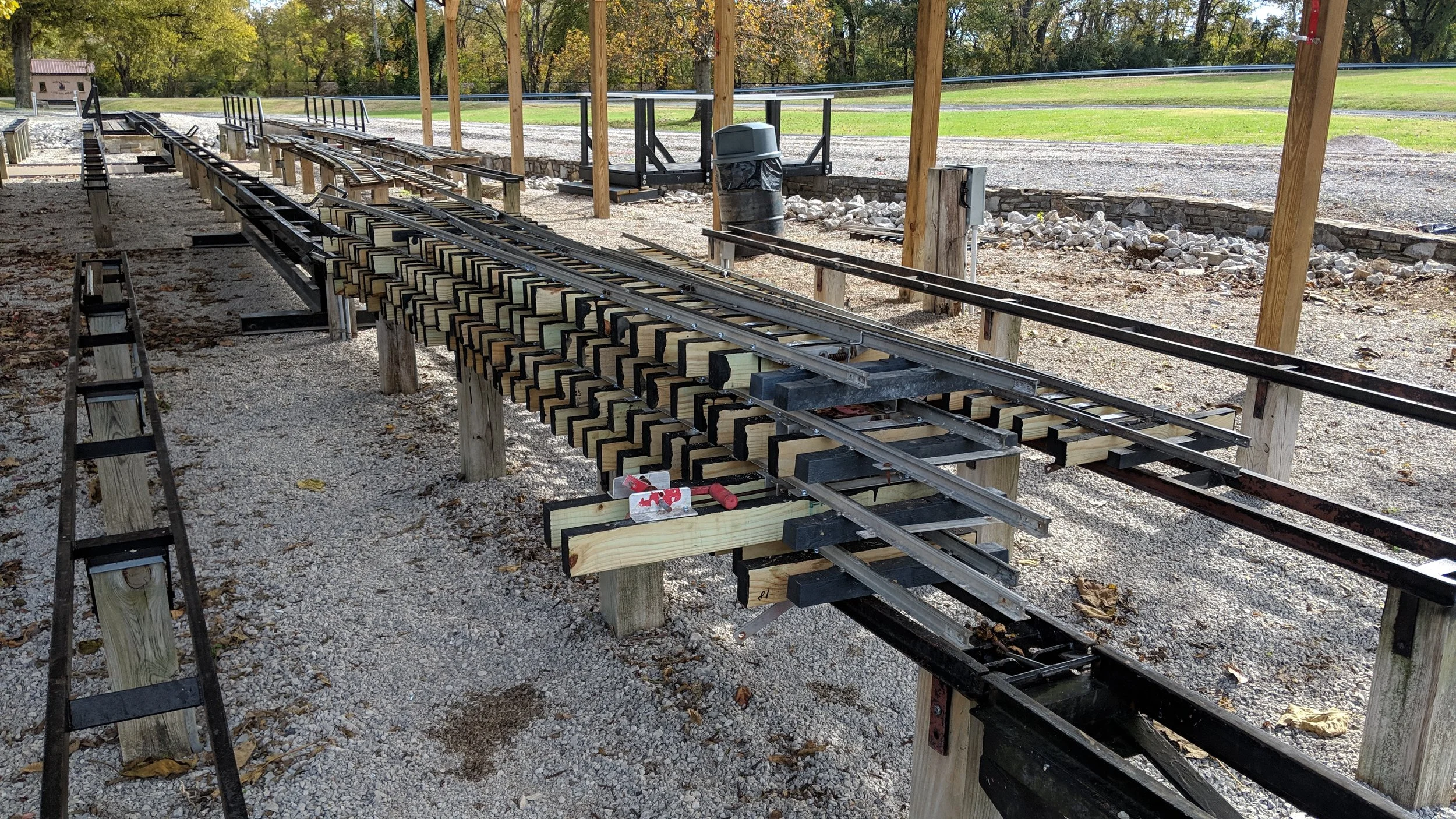

With good weather and a great work crew, the first phase of the steaming bay yard rebuild is underway. The first task today was to remove all the old track and switches. After that, the work crew began rehabilitation of the old switches. We were able to rebuild 50% of the switches and will work on the other half over the next few weeks.

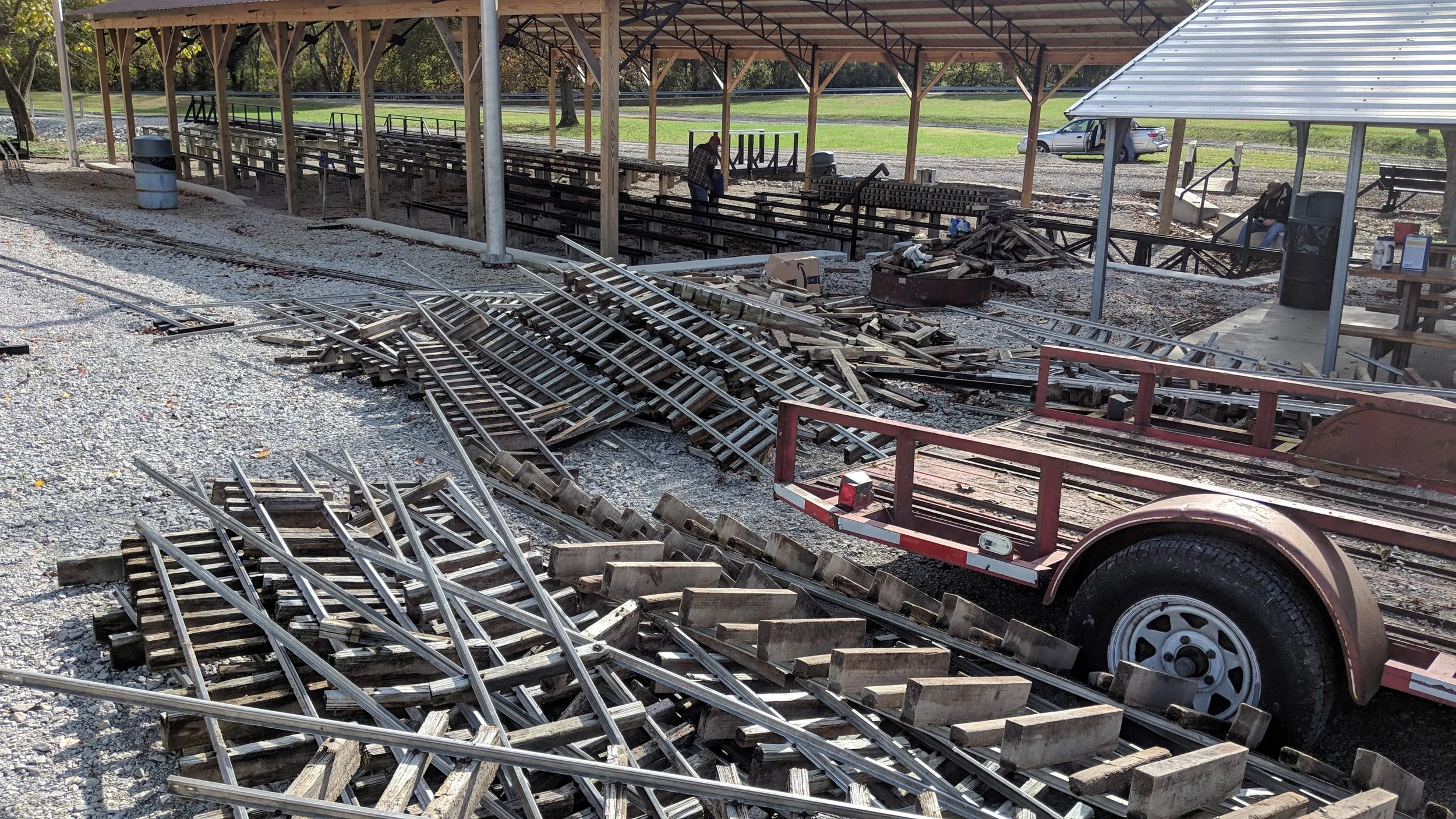

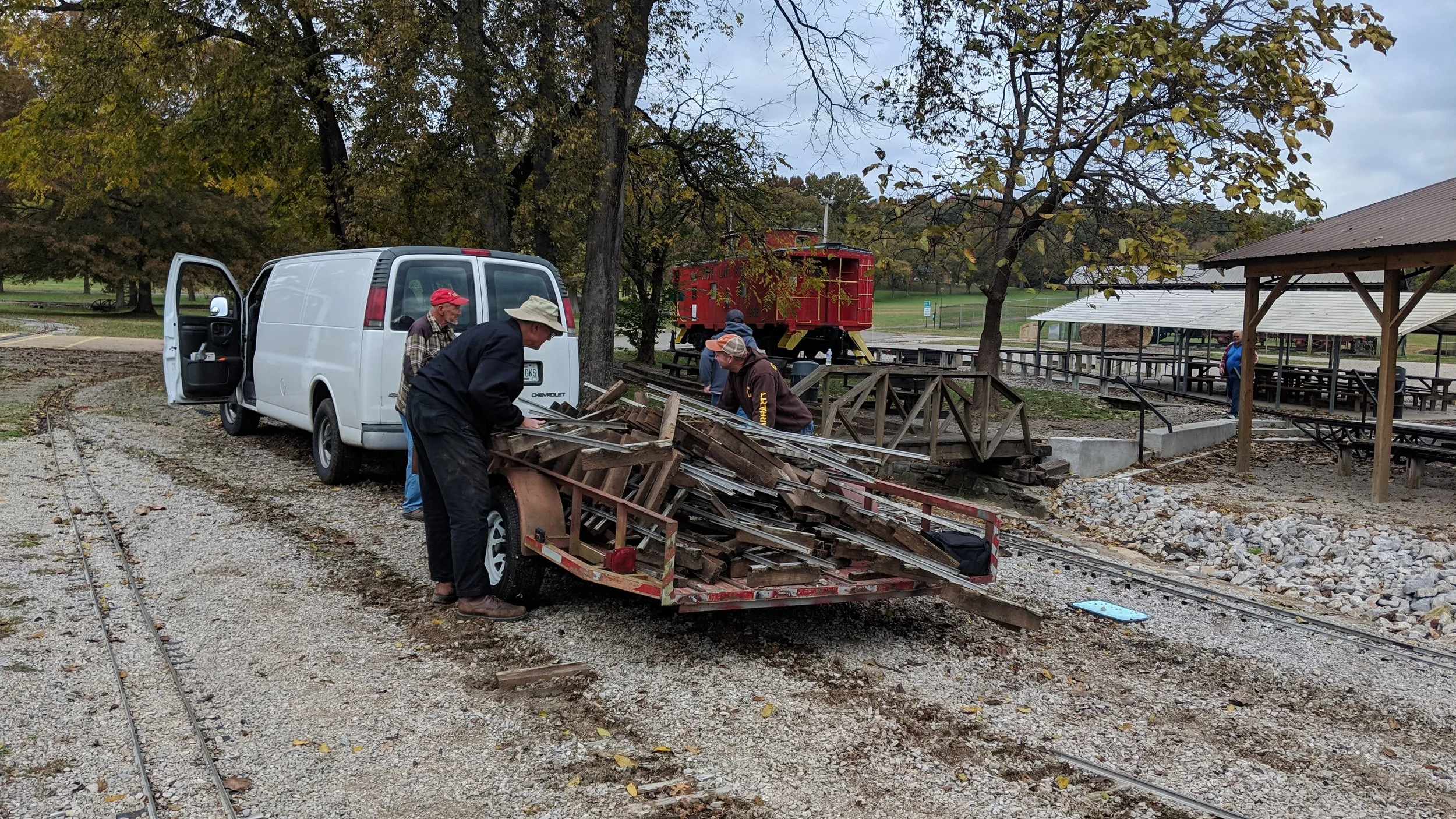

Here are some photos of the amount of track that was removed today. Next week, the track crew will begin to dismantle the old tracks panels.
